Robbins Celebrates Tough Tunnels for Clean Energy
Jun 02, 2017
Ceremony with Georgian Prime Minister commissions Green Power Station
In April 2017, a ceremony was held to celebrate the commissioning of the Dariali Hydropower Project in the Republic of Georgia. Many attended the ceremony marking the first carbon-neutral hydropower project in the world, including Georgian Prime Minister, Giorgi Kvirikashvili. The power station, an independent power project (IPP) developed through Dariali Energy Ltd, was a joint venture involving three other firms: Georgian private companies Peri Ltd and Energy LLC, and state-owned Georgian Energy Development Fund (GEDF).

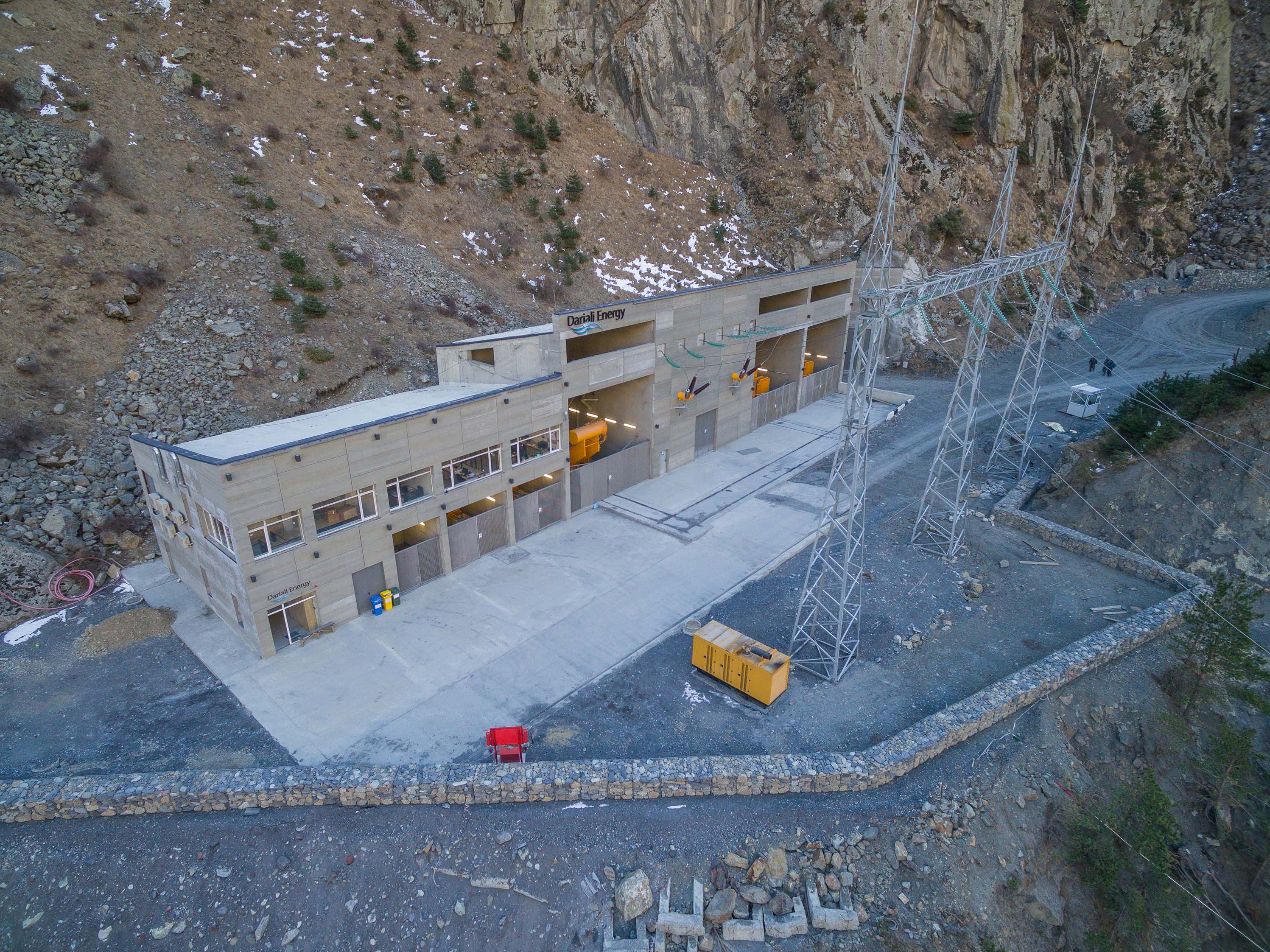

The Dariali HPP gathers water from the Tergi River and directs it through the headrace tunnel to the power house located near the Russian-Georgian border. Each year, the site will generate 500 GWhs of carbon-neutral energy, with 70 percent of power production occurring during the country’s summer months.
Robbins also invested in the project by gaining equity through supplying tunneling equipment and services in consortium with contractor Peri.

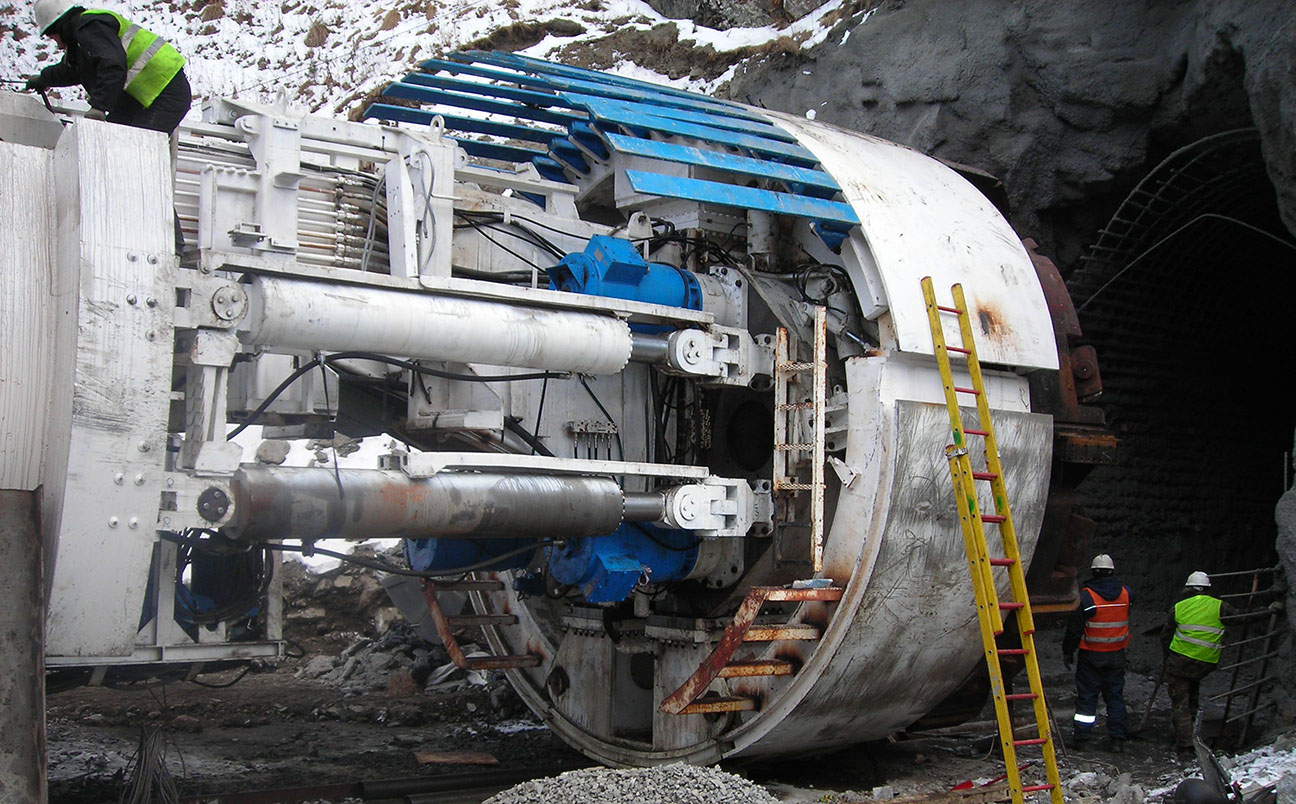

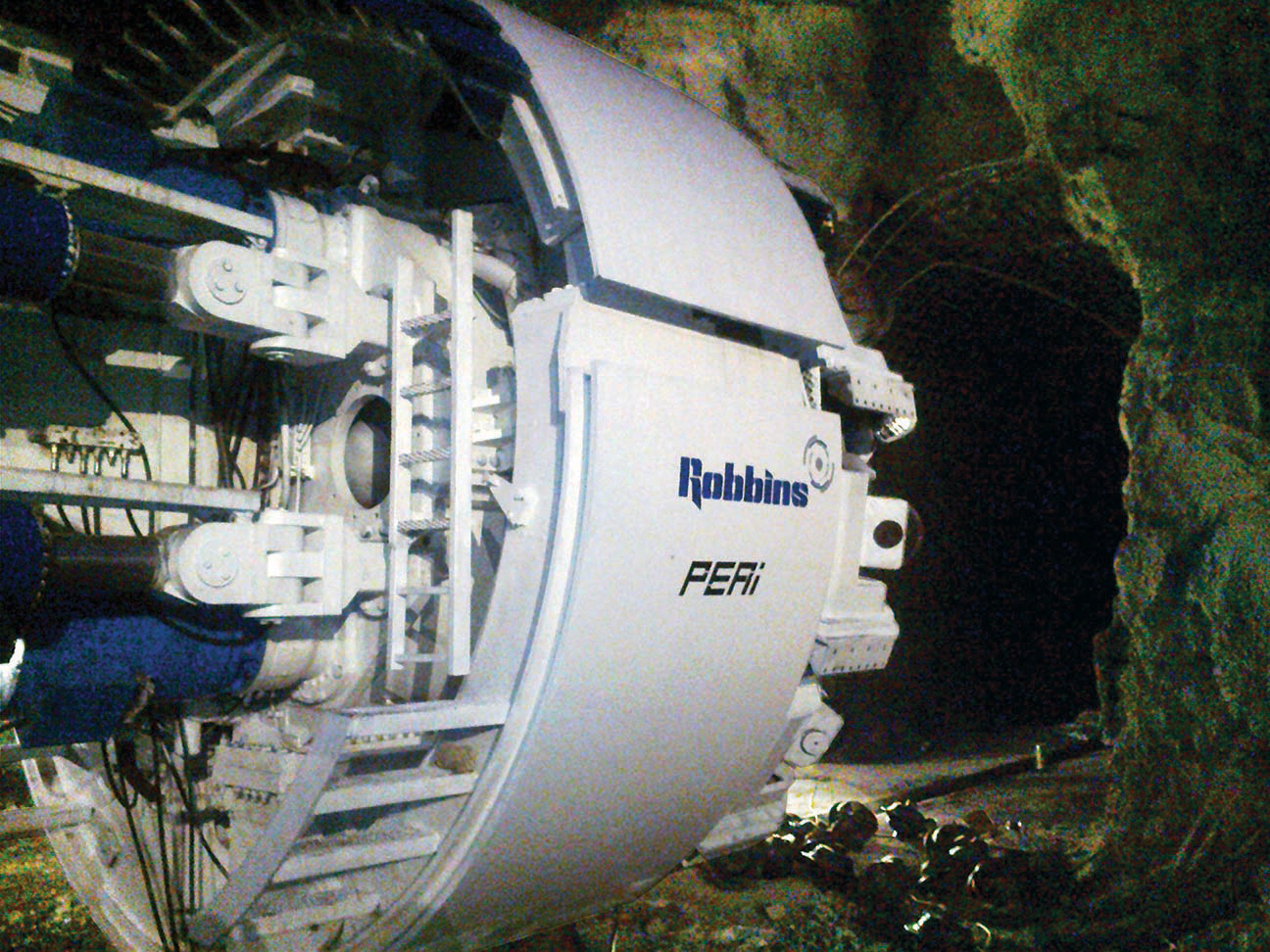

“Robbins understood the risk in the tunneling portion of the project and we were compensated for taking on part of the risk. Peri is a long-time customer, as we supplied a TBM to them 15 years ago for a small project in Georgia. It was great to be invited to invest and risk share on this project, and to work together again,” said Robbins President Lok Home. The 5 km (3 mi) long headrace tunnel for the power station was bored with the use of a 5.5 m (18 ft) diameter Robbins Main Beam TBM starting in February 2012.
Due to the remote and mountainous location of the jobsite 160 km (100 mi) from the capital Tbilisi, the machine was shipped in pieces to contractor Peri’s workshop, where they were refurbished under Robbins supervision and then delivered to the site to be assembled. Each piece was transported by truck down narrow, winding roads that eventually gave way to dirt paths.
Assembly at the jobsite was difficult, as the project site at a 1,700 m (1.0 mi) altitude was blanketed in snow and components arrived in December. Bone-chilling temperatures often reached negative 15 degrees Celsius (5ºF), and 40 below with the wind chill factor. Once the machine had launched, it encountered difficult ground including slate, sandstone, limestone and malms with fault zones.
“The main challenges we faced were boring the tunnel at a 6 percent incline and having restricted access to service the machine. There were also two major landslides that delayed the project for over a year,” said Home.

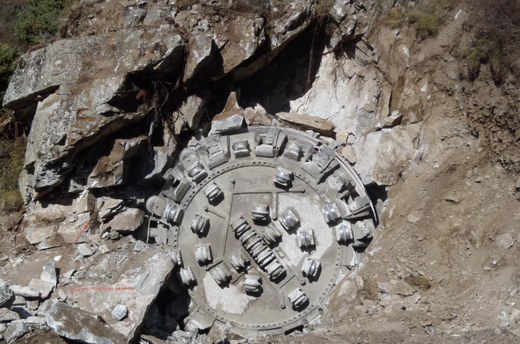

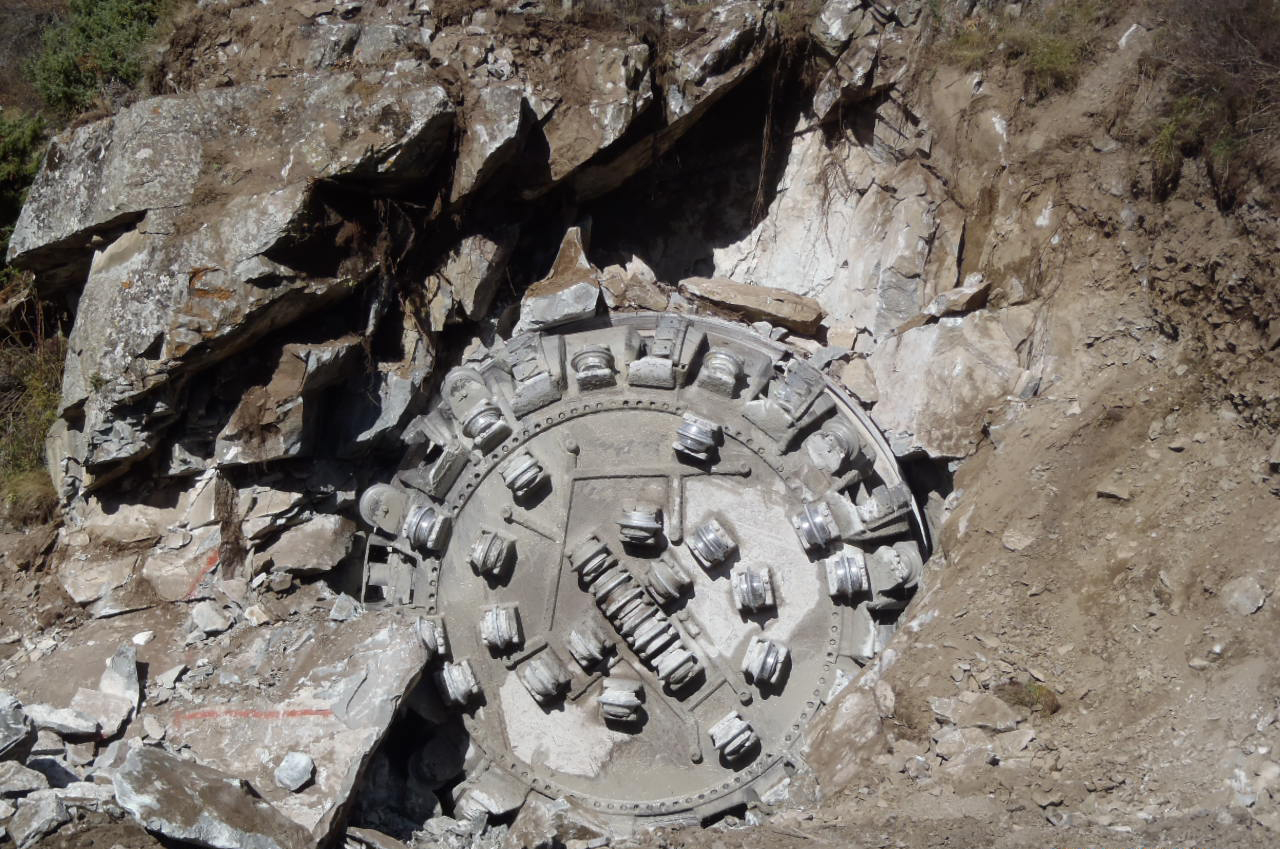

After the first landslide, the access tunnel, which had allowed mud and water to enter the power station, had to be relocated at a higher elevation and facing away from the river valley. When the machine was nearing the end of its bore, a second landslide blocked the exit portal for the machine as well as access to the main highway. Despite these challenges, tunneling crews persevered and the machine successfully holed through in October 2014.
Throughout the construction process, careful steps were taken to minimize the carbon footprint. Although the plant’s energy production is carbon emission free, construction of the plant was not. To offset these emissions, 7,000 seedlings are being planted all around the area in a reforestation effort. In years to come, the trees will absorb enough carbon dioxide to compensate for the emissions produced during the construction of the hydropower plant.
Overall, said Home, there is much to celebrate as the project has immense benefits: “Not only does it provide affordable electrical power for the country with essentially no pollution effects, but it also provided jobs during construction and will continue providing jobs during its operation and maintenance.”
More News and Articles
Mar 17, 2023
News
Trenchless manufacturer celebrates installation of 100,000th liner
SAERTEX multiCom®’s trenchless pipe relining product, SAERTEX-LINER, has been installed for the 100,000th time.
Mar 13, 2023
News
Spring collaborates with Microsoft and Impact X on water innovation
The water sector’s innovation centre of excellence – Spring - is collaborating with Microsoft and Impact X on a new initiative to make tools and funding available for start-ups to accelerate their companies.
Mar 10, 2023
Article
State of Global Water Resources report informs on rivers, land water storage and glaciers
WMO reports on freshwater availability in a changing climate
Mar 08, 2023
News
Australia: Centenarian sewer gets after-dark upgrade
Over 100 years since its inception, Brisbane’s S1 Main Sewer has undergone a seven-year upgrade.
Mar 06, 2023
News
UKWIR gives access to hundreds of water sector research reports
UK Water Industry Research (UKWIR) is providing free access to over 1,000 of its water sector research reports aimed at helping to improve water and wastewater services for customers, and protecting the environment.
Mar 03, 2023
News
Sector must challenge public misconceptions through engagement
The water sector must tackle “unfair criticisms” by sharing more about the great work it delivers, Yorkshire Water’s chief executive, Nicola Shaw, told attendees at British Water’s Better Together reception in Hull.
Mar 01, 2023
News
World-first project to ‘self heal’ cracked concrete using sludge could save $1.4 billion repair bill to Australia’s sewer pipes
Water treatment sludge could be used to prevent 117,000 kilometres of sewer pipes in Australia from cracking in future, without any intervention by humans, helping to save $1.4 billion in annual maintenance costs.
Feb 27, 2023
News
Delaware Water Treatment Plant Opts for Penetron to Protect New Concrete Structures
The final 2022 commissioning of the Doe Run Road Water Treatment Plant enables the city of Newark, Delaware (USA), to increase the quantity and quality of the city's drinking water to better meet growing demand – and EPA guidelines. PENETRON …
Feb 24, 2023
News
Aussie Trenchless: the future of pipe rehabilitation solutions
Aussie Trenchless has been passionate about progressing future infrastructure opportunities and accomplishing superior outcomes since it was founded in 2014.
Feb 22, 2023
News
IWA-Grundfos UN Water Conference youth delegates announced
The International Water Association and Grundfos are proud to announce that 14 bright and promising international young water professionals (YWPs) have been selected to be part of a delegation to the upcoming UN 2023 Water Conference, on 22-24 March 2023 …
Feb 20, 2023
News
Smart Lock makes short work: Hong Kong sewer drain repair
When the Hong Kong Drainage Services Department identified a badly damaged pipe, it was Smart Lock’s sleeve solution that empowered contractors to successfully rehabilitate the damaged section.
Feb 17, 2023
News
iMPREG celebrates UV Liner installation success in the UK
iMPREG has helped complete the task of installing an ultraviolet liner in the United Kingdom.
Contact
The Robbins Company
Desiree Willis
5866 S. 194th St.
WA 98032 Kent
United States
Phone:
+1 (253) 872 0500
Fax:
+1 (253) 872 4490
